Columbia County West End Flood Mitigation Projects & Columbia County West End Flood Risk Management Systems
Welcome, and thank you for visiting the official webpage for the West End Flood Mitigation Projects. Columbia County Commissioners, in coordination with SEDA-Council of Governments (SEDA-COG) and the engineering firm, are continuing long-term efforts to address recurring flooding in the West End of Bloomsburg.
These projects build on previous flood studies and earlier flood wall investments, representing the next phase of work to reduce flood risks, protect homes and businesses, and strengthen critical infrastructure. The focus remains on improving safety and resilience for the community while planning responsibly for future flood events.
Residents, property owners, and stakeholders are encouraged to use this page to stay informed about updates from the projects, such as key milestones, and upcoming activities.
For questions or additional information, please contact bloomsburgfloodproject@seda-cog.org
These images show prior flood mitigation work and studies completed in the West End of Bloomsburg, including photos from the historic 2011 flood caused by Tropical Storm Lee. The projects discussed on this page build on this earlier work.









Goals of the Projects
Reduce Flood Risk for West End Residents
The County aims to significantly reduce the risk of repeated flooding for more than 350 homes in the West End of Bloomsburg by making targeted improvements that better manage floodwaters.Make Targeted Improvements to the Floodplain
• U.S. Route 11 Elevation Modifications
• Bloomsburg Fairgrounds Swale Construction
• Fishing Creek Channel RealignmentPrepare for Future Levee Improvements
The County will complete the necessary steps to meet federal requirements for future levee construction by demonstrating meaningful reductions in flood levels.Position the Projects for Future Construction Funding
The County will advance engineering, permitting, and planning work so the projects are ready to pursue future construction funding when opportunities become available.Strengthen Community Resilience and Emergency Preparedness
The County will support long-term flood resilience while aligning this effort with broader emergency preparedness and hazard mitigation planning.Coordinate with Local, State, and Federal Partners
The County will continue working closely with municipal, state, and federal partners to ensure the projects are transparent, well-coordinated, and responsibly managed.
Timeline & Milestones
How The Project is Moving Forward
The Columbia County Commissioners are leading a series of coordinated flood mitigation projects in the West End of Bloomsburg. Rather than a single construction effort, this work is advancing through individual projects, each designed to reduce flood risk and prepare for future improvements.
Current Projects Underway
The County is currently focused on planning and design work that supports long-term flood protection, including:
- Design preliminary flood protection improvements in key areas of the West End
- Coordinating with state and federal agencies to ensure all work meets applicable standards
- Identifying property access needs, such as easements, to support future construction
- Completing studies and testing needed to prepare projects for construction funding
Preparing for Future Flood Protection and Insurance Relief
In addition to current planning and design work, the County is preparing for future projects that could improve flood insurance outcomes for residents. This includes:
- Evaluating existing flood protection systems to determine what improvements are needed to meet federal standards
- Developing emergency response and operation plans to ensure systems can be safely maintained over time
- Working with Federal Emergency Management Agency (FEMA) to support future updates to flood maps once requirements are met
- Keeping residents informed about what these improvements could mean for flood risk and insurance requirements
If these future steps are completed and fully funded, they could reduce the number of properties required to carry flood insurance.
What This Means for Residents
At this time, the County is not beginning major floodwall or levee construction. The current focus is on careful planning, coordination, and preparation to ensure that future flood protection projects are effective, fundable, and aligned with community needs.
Project timelines will continue to be refined as each individual project moves forward.

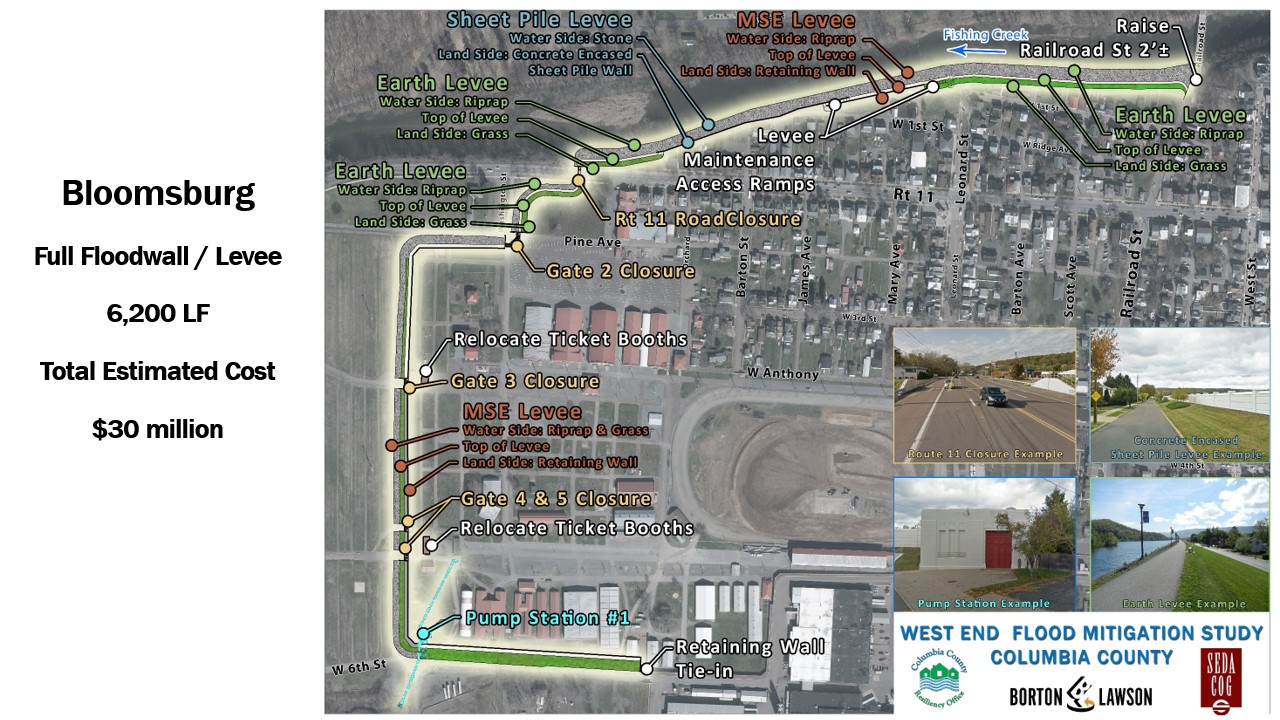

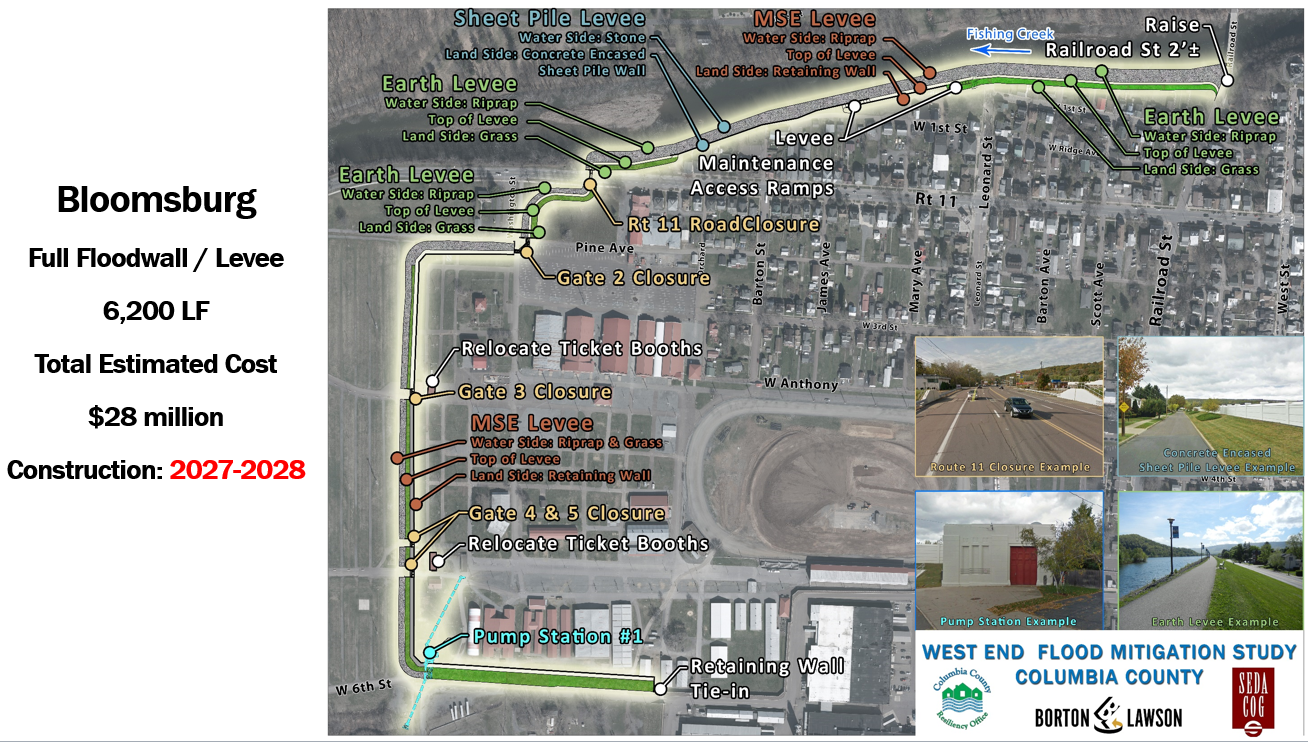

Project Map
Upcoming Events
There are currently no public meetings scheduled for the West End Flood Mitigation Project.
Project partners continue to advance engineering, environmental review, permitting, and funding activities. When the next public meeting or stakeholder engagement opportunity is scheduled, details will be posted here and shared through Columbia County communication channels.
Resident Quick Facts
Who is leading the projects?
The projects are led by the Columbia County Commissioners, with support from SEDA-COG and engineering consultant.Are these new projects?
No. These projects continue earlier flood studies and past flood mitigation work in the West End of Bloomsburg. The current phase builds on that prior investment.What are the goals of the projects?
The goal is to reduce flooding in the West End by improving how floodwaters move through the area and preparing for possible future levee or floodwall construction.How will this help Residents?
These projects are expected to:• Lower flood levels during storm events
• Reduce flood damage to homes and infrastructure
• Improve long-term safety and resilience for the communityWhat is happening right now?
The County is focused on:
• Planning and engineering
• Retaining Real Estate Professional Service Providers
• Early floodplain improvements
• U.S. Route 11 Elevation Modifications
• Bloomsburg Fairgrounds Swale ConstructionThis work helps reduce flood levels and prepares the projects for future construction funding.
- Is a levee or floodwall being built now?
No. A levee or floodwall could be considered in a future phase, after required mitigation improvements are completed and additional funding is secured. - Will properties be taken or residents displaced?
Some temporary or permanent easements may be needed as the design progresses. Property owners who may be affected will be contacted directly by the projects’ retained real estate professionals. How are these projects being funded?
Current funding (approximately $7 million) comes from state and federal sources. Additional funding (estimated at $30+ million) will be needed for future construction phases.Will flood insurance still be required if a levee is built?
If a future levee or floodwall meets federal standards, flood insurance may no longer be required for federally backed mortgages. However, flood insurance is still recommended because some flood risk always remains.Who will maintain the system in the future?
The Columbia County Water Mitigation Authority will be responsible for the long-term operation and maintenance of the system to ensure it continues to meet safety and performance standards.How can residents stay informed?
Updates will be shared on this webpage and through public meetings as the projects move forward.
What These Project Are — and Are Not
✔ A continuation of past flood mitigation work
✔ Focused on long-term flood risk reduction
✔ Moving forward in phases
✖ Not immediate levee construction
Past Public Meetings & Resources
May 6, 2026 Public Meeting – Questions and Answers
As part of the public engagement process, attendees were invited to submit questions regarding the project. The project team has reviewed those questions and prepared the responses below. This information is intended to provide additional clarity and support continued transparency throughout project development.
- How much of the $6.8 million of funding secured for the Risk Mitigation System has been spent? How much has been spent on the engineer to date?
Over five years, the county has been under contract with Borton-Lawson (now Verdantas) to undertake engineering study efforts which has cost roughly $1 million to undertake.
The approximately $6.8 million is all funding that is unspent at this time and earmarked for the various projects moving forward. In addition, the County has applied, or is in the process of applying, for approximately $3.5 million in additional funding. If awarded, this funding would fully finance the three primary mitigation projects and support preliminary engineering for the levee system components. These efforts are being coordinated in partnership with SEDA-COG. - When will information be shared again publicly with the community on costs have been allocated to specific Mitigation projects and activities?
The County Commissioners will approve all projects’ contracts in their regularly scheduled public meetings. Another public informational meeting will be held in later 2026 to update the public concerning the projects’ development including cost updates. Information concerning another informational public meeting will be published once more tangible projects updates are available. Additional informational public meetings will continue to occur in the future. Ongoing questions concerning the projects’ can also be directed to bloomsburgfloodproject@seda-cog.org. - Are the hydrologists going to be the same company bidding on the project?
Since the May 6th public meeting, the county has retained the firm Verdantas to proceed with engineering efforts for the various projects. Verdantas has hydrologists on staff which participate in the previous study efforts and will be active as the projects proceed to permitting. - We know there is gravel that is being deposited on the bank to prevent sediment from accumulating in Fishing Creek. Does the sediment only come from one spot or does it come from other areas?
The existing islands in the creek are proposed to be removed. However, because the channel is so wide at this point, the island will simply return within 5 years unless the stream banks are narrowed to maintain channel velocity and sediment transport downstream. The sediment which comprises the islands originates from areas and tributaries all throughout the Fishing Creek watershed. - Can we have an independent review of the engineer’s information and preliminary studies/designs?
The previous study documents are all publicly available and can be viewed at the following links: - Will there be 3D modeling done? What kind of modeling will be done? (Something about incorporating and revisiting Bloomsburg studies…I’m not sure where and which ones these are).
The hydraulic modeling is completed in 2D. While 3D CFD (computational fluid dynamics) modeling is possible, that is usually used in very niche applications such as dam spillways, pumps, fluid mixing applications, etc. The Civil design elements are 3D compatible and can be rendered for visualization purposes if desired, but this usually requires some additional effort. - Has SEDA-COG ever administered a project of this magnitude and complexity?
Yes. SEDA-COG has successfully overseen multiple large-scale flood mitigation projects comparable in scope and complexity.For example, SEDA-COG managed a flood risk management system in Bloomsburg that included approximately $30 million in combined public and private investment. This project provided protection for major employers such as Autoneum North America, Inc. and Windsor Foods, helping to safeguard approximately 800 jobs, and was completed in 2016.
Building on that effort, the Town of Bloomsburg—working in collaboration with the Bloomsburg Area School District—undertook an additional $17 million flood mitigation project. Completed in 2020, this project included a flood study and construction of a flood wall along West 12th Street, protecting key community assets including schools, residential properties, small businesses, and the town’s only fire department.
Together, these projects demonstrate SEDA-COG’s experience in managing complex, multi-phase flood mitigation efforts involving significant funding, multiple stakeholders, and critical infrastructure.
- Will Columbia County commissioners help the people of Fernville by including an emergency access road as part of this effort? Why is it not included in the current design?
The Fernville emergency access road is a separate project that is not part of the current West End Flood Mitigation and Risk Management System. Because it serves a specific local need within Hemlock Township, it needs to be advanced as an independent project led by the township.That said, the Columbia County Commissioners recognize the importance of improving access and safety for Fernville residents and are willing to collaborate with Hemlock Township in support of this project.
- What happened to Borton-Lawson and their engineering plans?Borton-Lawson was acquired by the firm, Verdantas. The study plans’ links are provided above.
- What are all the projects that need to take place before the levee is built? (Context: backup water from the storm systems that get backed up from fishing creek)
The sequencing of the mitigation projects are as follows before a levee system can be built with estimate construction dates:- US Route 11 Profile Adjustment (mid-2027)
- Bloomsburg Fairgrounds Swale Construction (mid-2027)
- Fishing Creek Channel Modifications (mid-2028)
- Is lowering route 11 going to make flooding worse on one side of the road? How will residents get in and out of the road?Lowering Route 11 by one foot does allow greater volumes of floodwater to spill into the fairground’s parking fields. Route 11 will be closed during a flood whether a) because Route 11 is flooded or b) because the closure structure across Route 11 has been closed. Residents would have egress to the east through town. The expected frequency of roadway flooding is not expected to be appreciably greater than present conditions.
- Is the creek going to get cleaned up in Fernville past route 80? The water doesn’t even flow at the beach anymore.
The project does not extend beyond the Railroad Street bridge. - Is there a wall being considered in Fernville?
The Columbia County West End Flood Mitigation Study Final Report concluded that “structural mitigation is not feasible for th(is) municipal(y) (Hemolock Township) since the low density of structures results in a low benefit to cost ratio. “ A Benefit-Cost Analysis (BCA) is a method used to evaluate a project by comparing its expected benefits to its costs, and it is commonly required in federal funding decisions to demonstrate that a project provides sufficient economic value to justify investment of public funds. The link to this study is previously provided. - Will lower creek levels eliminate the need to lower Route 11?
Lowering Route 11 is one of the primary mechanisms by which the creek levels are lowered back to current conditions. All mitigation features work in conjunction with one another to achieve this goal. - How are flood waters being directed and why are they being directed to the fairgrounds? Will this have more negative impacts to the already flood-prone fairgrounds and businesses located there?
Flood waters naturally seek a path into the floodplain once levels exceed the banks. Modeling and damage assessments after Tropical Storm Lee showed high flow and high overtopping velocities in the 900 block of West Main St. The current concept aims to take advantage of this natural flow pattern and return floodwaters to the floodplain as quickly and as efficiently as possible to control flood levels on Fishing Creek. The open fields of the fairgrounds offers a convenient, undeveloped area of the floodplain for energy dissipation and storage of floodwater.Modeling showed minimal impacts to the Barn at Boones Dam property as a result of this concept as waters are significantly dispersed by the time they travel from Route 11, through the fields, and back to the creek. Because FEMA requires demonstration of zero increases in flooding at structures, a 6’ high berm is proposed on Fairgrounds property to shield the property from impacts resulting from the lowering of Route 11. With the berm in place, modeling shows no change to current flood depths or velocities due to the project.
- Suggestion for a question: What are the phases of this large Mitigation effort, and why is it so important to complete the initial Mitigation projects before the levee is built?
See above for sequencing of the mitigation projects. The following is provided from Addendum #2: 2-Dimensional Hydraulic Analysis Final Recommendations:“The Fishing Creek floodway is situated such that a proposed levee system would be constructed entirely within the regulatory floodway along the left descending bank of Fishing Creek, downstream of Railroad Street. Results of the 2D proposed conditions stream modeling performed in the Amendment No. 1 work indicated that the water surface elevation (WSEL) of the base flood increases by as much as 2.1 feet when a levee is constructed along the left bank of Fishing Creek without mitigation features. Without mitigation of the induced flooding, the residential areas in Hemlock Township adjacent to and upstream of the proposed levee would experience a greater risk of flooding because these areas would not be protected by the proposed levee. The recommended mitigation project will reduce the 2.1 feet of induced flooding predicted in the original West End Flood Mitigation Study to a zero increase for the base flood conditions, necessary for permitting of the levee systems.”
Project information, schedules, funding status, and technical details may evolve as engineering, permitting, environmental review, and funding activities progress. Responses are based on information available at the time of publication.
